Beardsley Land Clearing puts Surprise property owners in contact with a local land clearing contractor for commercial site clearing in Surprise and across the Northwest Valley side of Maricopa County.

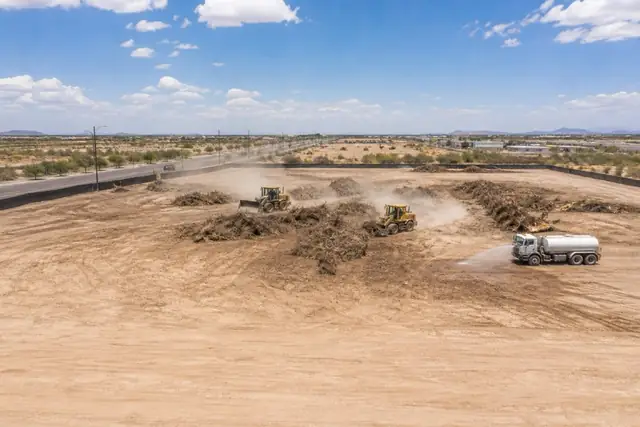

At commercial scale the clearing itself stops being the hard part. Machines are the easy variable; the difficulty is compliance, sequencing, and keeping several trades from tripping over each other on the same ground. A twenty-acre parcel is not a five-acre parcel four times over.
Three regimes attach almost immediately. Air quality permitting and a trained on-site dust supervisor come from the county. Storm water permitting and a written pollution prevention plan come through the state under the federal construction general permit once disturbance reaches an acre. Grading, drainage, and any protected-plant obligations come from the local jurisdiction and the state agriculture department. None of these are optional and all of them have lead times.
Phasing is the tool that keeps a large site out of trouble. Clearing everything at once maximizes exposed surface, which maximizes both dust liability and erosion risk, and on a project whose vertical construction is sequenced anyway there is rarely a reason for it. Clearing in blocks that track the build sequence keeps disturbed area low and stabilization manageable.
The last piece is honest reporting. Inspections, rain events, dust complaints, and control measures all get logged, and on a site of any size that record is what an inspector reads first. It is unglamorous and it is the difference between a routine visit and a notice of violation.
The permits that gate a commercial start
Earthmoving above the county's disturbance threshold requires a dust permit and a supervisor who has completed the county's control training, applied for through the permit portal. Storm water coverage for sites of an acre or more follows the framework described in EPA's material on construction discharges, administered in Arizona by the state environmental agency.
Locally, grading and drainage plans go through the City of Surprise development services counter where the parcel sits inside city limits, and through the county where it does not. On raw desert ground, the protected native plant notification runs on its own clock and should be filed early rather than discovered during mobilization.
Keeping a large disturbed surface stable
The hardest thing to manage on a big site is exposed area during the gap between clearing and construction. Chip from the clearing operation spread as surface cover, chemical stabilizers, gravel on haul routes, and simply not opening ground until it is needed all do real work here. Regional particulate conditions are published through the national air quality index, and high pollution advisory days are a reasonable trigger to pause dusty operations.
Summer adds wind. Outflow boundaries described in dust storm safety material arrive fast and can strip an unstabilized surface in minutes, which is why a large site gets left in a defensible condition at the end of each day rather than mid-operation.
Sources & further reading
Questions worth settling before a machine is booked
What is the realistic lead time before machines can start?
Permitting drives it. Dust permitting is comparatively quick, storm water coverage takes longer, grading plan review depends on the jurisdiction's queue, and protected native plant notification adds its own window on undisturbed desert ground. On raw acreage it is prudent to assume weeks rather than days, and to start the plant notification first.
Does the whole site have to be cleared at once?
No, and usually it should not be. Phasing clearing to match the construction sequence keeps disturbed acreage low, which reduces dust exposure, erosion risk, and the amount of surface that has to be actively stabilized. It also spreads cost. The main argument for clearing everything early is mobilization efficiency, and it is usually the weaker argument.
Who has to hold the dust training certificate?
The county expects a responsible person on the site to have completed its dust control training, and for that person to be reachable during operations. On a multi-contractor site this is a coordination question — it needs to be clear in the contract who carries it, because an inspector arriving to find nobody accountable is a bad outcome for everyone.
How is the cleared vegetation handled at volume?
Mostly it is ground on site. Chipping tens of acres of mesquite and creosote and hauling it away is expensive and unnecessary when the resulting material has a use as surface stabilization on the same project. Where the site plan needs bare finished grade, the chip gets windrowed and either used elsewhere on site or removed as a distinct line item.
Can clearing proceed while the plant notification is pending?
Not on the protected plants themselves. The notification period exists so the state can inspect or arrange salvage, and clearing through it defeats the purpose and creates real exposure. Work that does not touch protected species — access, staging, non-protected vegetation — can often proceed, but that boundary should be drawn on a map, not assumed.
